Production Schedule /Turnaround Times
Generally, we operate in two-week windows for ordering and production. We gather orders for two
weeks and then submit all finalized orders to our factory at one time. An exception to this would be a legacy CSD Team Store that is open for longer than two weeks. In this case, all orders placed in that store will be submitted together once the store closes. Ship dates for these orders still follow the ORDER CUTOFF/SHIP DATE table.
The Submit Orders to Factory date is the same as the TWO WEEK ORDER CUTOFF listed
in the table below the diagram. Once orders are submitted, production
takes about two weeks to produce and ship. This is a super fast
turnaround by the way! So, depending when you place your order

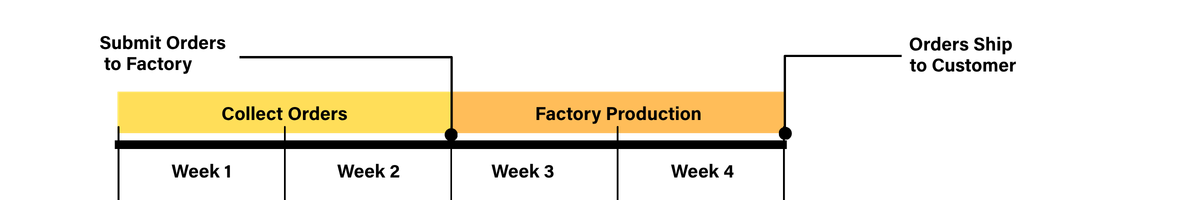

inside of the two week Collect Orders windows, it will look like 2-4 weeks turnaround time. See diagram below for two-week windows.

The closer an order is placed to the right side of the yellow Collect Orders box, the shorter the turnaround time appears. If you order right before the TWO WEEK ORDER CUTOFF/Submit Orders to Factory date,
the closer you get to a turnaround of about two weeks. If you order at
the beginning of that two week period, it will appear more like a four
week turnaround.
Below is our production schedule. The TWO WEEK ORDER CUTOFF is the day listed at 5pm Central Time.
TWO WEEK ORDER
CUTOFF |
SHIP DATE |
| June 16, 2026 |
July 2, 2026 |
| June 30, 2026 |
July 16, 2026 |
| July 14, 2026 |
July 30, 2026 |
| July 28, 2026 |
August 13, 2026 |
| August 11,
2026 |
August 27, 2026 |
| August 25,
2026 |
September 10, 2026 |
| September 8,
2026 |
September 24, 2026 |
| September 22,
2026 |
October 15, 2026 |
| October 13,
2026 |
October 29, 2026 |
| October 27,
2026 |
November 12, 2026 |
| November 10,
2026 |
November 26, 2026 |
| November 24,
2026 |
December 10, 2026 |
| December 8,
2026 |
December 24, 2026 |
| December 22,
2026 |
January 7, 2027 |
* 5pm Central Time
If this chart is out of date, email us and we will give you an updated schedule.
Related Articles
Dedicated Store
Champion System is one of few custom apparel companies that gives you the ability to have a team/group store open 24/7 with no minimums required once you meet minimums on your first order. Orders are submitted to our factory every two weeks and ...
AI Designs
AI generated designs are a great way to visualize what your custom apparel design could look like. While these tools are great for brainstorming and inspiration, AI images are not directly usable for production. Here’s why: AI images are raster ...
